What is SAP Data Migration?

SAP Data Migration is the work of moving data out of legacy or existing systems and into SAP, so the target system starts life with records that are accurate, complete, and ready to use.

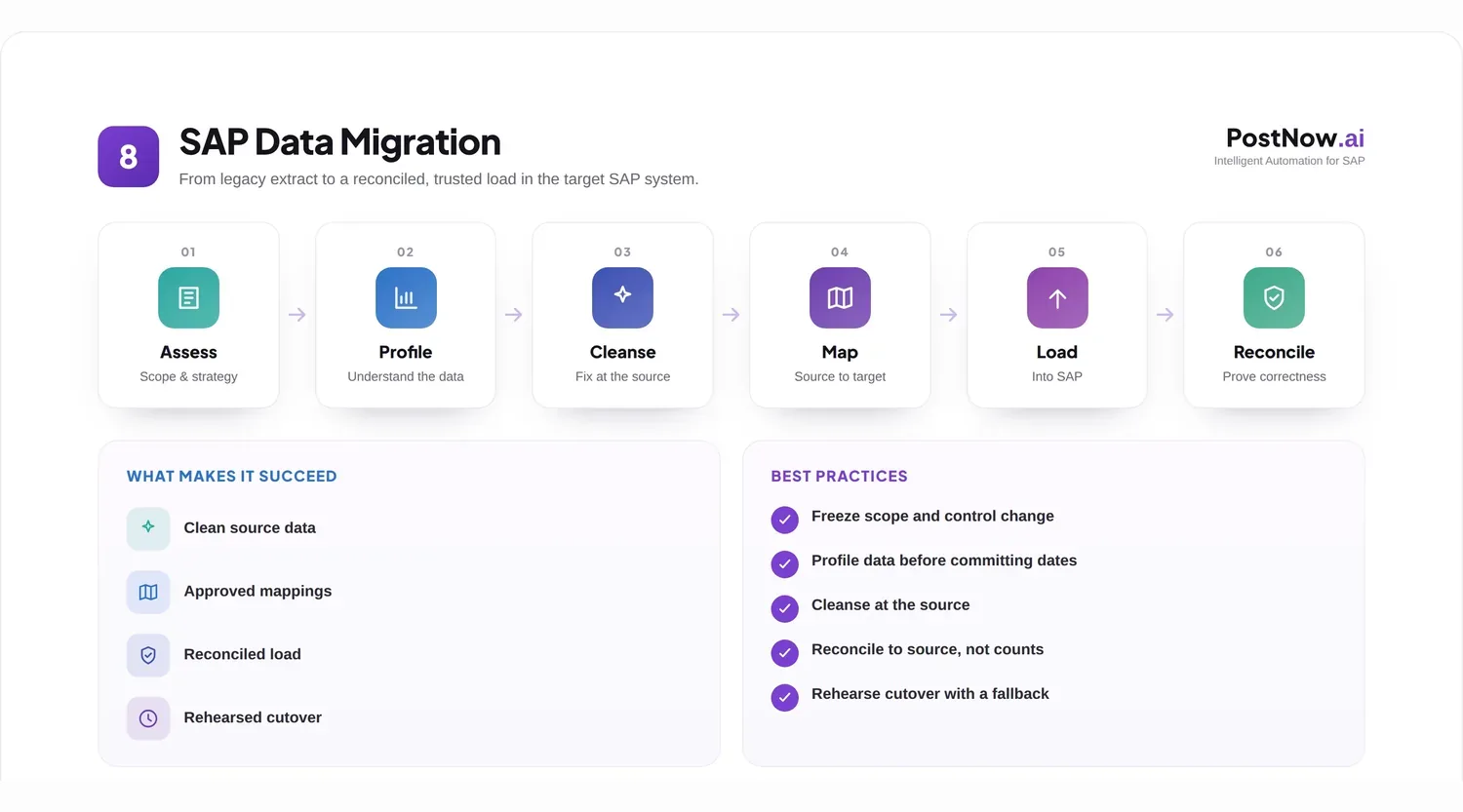

SAP data migration lifecycle infographic: assess, profile, cleanse, map, load, and reconcile from legacy systems to S/4HANA.
The full journey of moving data into SAP, with quality checks built into each stage.

That data falls into two broad camps. Master data is the reference information that endures, such as suppliers, customers, and materials. Transactional data is the activity that flows against it, such as open invoices, orders, and stock balances. A migration usually has to handle both.

Organizations rarely migrate for its own sake. They move data because they are replacing an ageing platform, merging systems after an acquisition, retiring a tool that is no longer supported, or stepping up to S/4HANA. In each case the data has to come along, and it has to arrive in good shape.

Common scenarios include a fresh SAP implementation that pulls history from older software, a consolidation that merges several regional systems into one, and a conversion that lifts an existing ECC landscape onto S/4HANA. The mechanics differ, but the goal is the same: trustworthy data on day one.

For the program managers, architects, and data teams who run these projects, the day to day reality is less about moving bytes and more about decisions: what to bring, what to leave, and what good enough looks like for each object. A clear approach turns those decisions into a plan the whole team can follow.

💡
In short: data migration is how an organization carries its records into SAP, turning whatever sits in the old systems into clean, validated data the new system can rely on.

Migrations are run by a mix of people: program managers who own the timeline, architects who shape the target model, consultants who know the objects, and the business owners who decide whether a record is right. Treating data migration as a shared effort, rather than a purely technical handover, is what keeps the result usable for everyone who depends on it.

Why SAP data migration projects matter

A migration is often the largest single data event an organization goes through, and its outcome shapes how well the new system performs for years.

ERP modernization

Moving to a current platform unlocks new capabilities, but only if the data underneath arrives clean enough to use them.

Business continuity

A smooth cutover keeps invoicing, shipping, and reporting running, so the business barely feels the switch.

Data quality

Migration is a rare chance to leave bad records behind rather than copying old problems into a brand new system.

System consolidation

Bringing several systems into one removes duplication, but it demands careful matching so nothing is lost or doubled.

Regulatory requirements

Auditors expect to trace what moved and to see that balances reconcile, so a defensible migration is part of compliance.

A platform to build on

Clean migrated data becomes the foundation for automation, analytics, and better decisions long after go-live.

Because so much rides on the result, migration deserves to be treated as a discipline in its own right, not a task squeezed into the final weeks of a wider program.

Types of SAP data migration

Most projects split their scope into master data and transactional data, because the two behave very differently and need different handling.

Master data migration

Master records are loaded first, since transactions reference them. They change slowly but carry many fields and rules.

ObjectWhat moves
VendorSupplier records across general, accounting, and purchasing data.
CustomerAccount records across sales, accounting, and general data.
MaterialItem records across the views each plant and function needs.
Business PartnerThe unified S/4HANA entity that carries customer and vendor roles.
Cost CenterControlling objects with hierarchy and validity dates.
Profit CenterResponsibility objects within the controlling area.

Transactional data migration

Transactions are loaded after the master data they depend on, and usually only open or recent items come across rather than full history.

ObjectWhat moves
Journal entriesOpening balances and in-flight finance postings.
Purchase ordersOpen commitments still expecting goods or invoices.
Sales ordersOpen demand not yet delivered or billed.
InventoryStock balances brought in as opening quantities.
Open itemsOutstanding receivables and payables carried forward.

Deciding how much history to bring is a project choice in itself. Many teams keep the new system lean and archive the rest, rather than reloading years of closed documents.

Sequencing the two types correctly is essential. Master data has to exist before the transactions that point to it can load, so a missed dependency in the master layer surfaces as a wave of failures further down. Mapping those dependencies up front saves a great deal of rework during testing.

Common SAP data migration challenges

The same obstacles appear on most projects, and almost all of them start in the source systems rather than in SAP.

  • Poor data quality, where legacy records are incomplete, outdated, or simply wrong.
  • Duplicate records, where the same entity exists several times and has to be matched and merged.
  • Legacy data issues, such as free-text fields, retired codes, and structures that have no clean equivalent in SAP.
  • Mapping complexity, where source fields do not line up neatly with the target model.
  • Data cleansing, which is almost always larger than first estimated.
  • Testing challenges, where there is never quite enough time to trial every object and edge case.
  • Cutover risk, where the final load has to land inside a tight window with little room for error.

None of these is insurmountable, but each rewards being found early. A problem spotted during discovery is an inconvenience; the same problem found during cutover is a crisis.

SAP data migration lifecycle

A migration runs through a recognizable set of phases. Naming them keeps the work visible and stops steps from being skipped under time pressure.

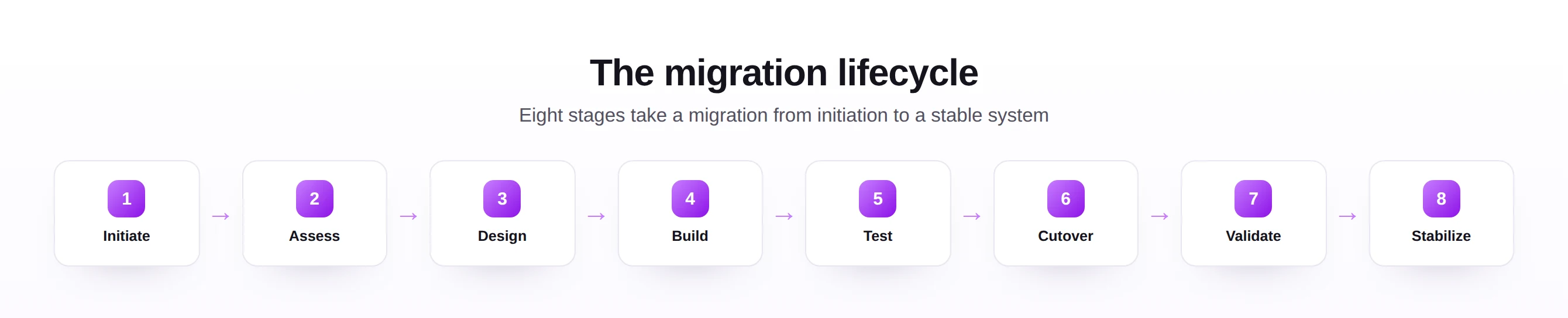

SAP data migration lifecycle with nine phases from assessment through post go-live support.
Diagram Nine phases carry data from first assessment to a stable, reconciled go-live.
Assessment
Agree the scope, the source systems in play, and what success looks like.
Data discovery
Profile the source data to learn its real shape, volume, and condition.
Data cleansing
Correct, complete, and deduplicate records, ideally at the source.
Data mapping
Decide how each source field becomes a field in SAP.
Transformation
Reshape and convert the data into the target structures.
Validation
Check records against SAP rules before they are loaded.
Testing
Run mock loads, then compare results and fix what breaks.
Cutover
Execute the live load inside the planned window.
Post go-live support
Reconcile, monitor, and resolve issues as the business starts to transact.

In practice the phases overlap and repeat rather than running in a strict line. Discovery often reopens as testing reveals new quirks in the source, and cleansing continues well into the trial loads. The value of naming the phases is not rigidity; it is making sure none of them is quietly dropped when the schedule tightens.

SAP ECC to S/4HANA data migration

For many organizations, the migration that matters most is the move from SAP ECC to S/4HANA, which is as much a data exercise as a technical one.

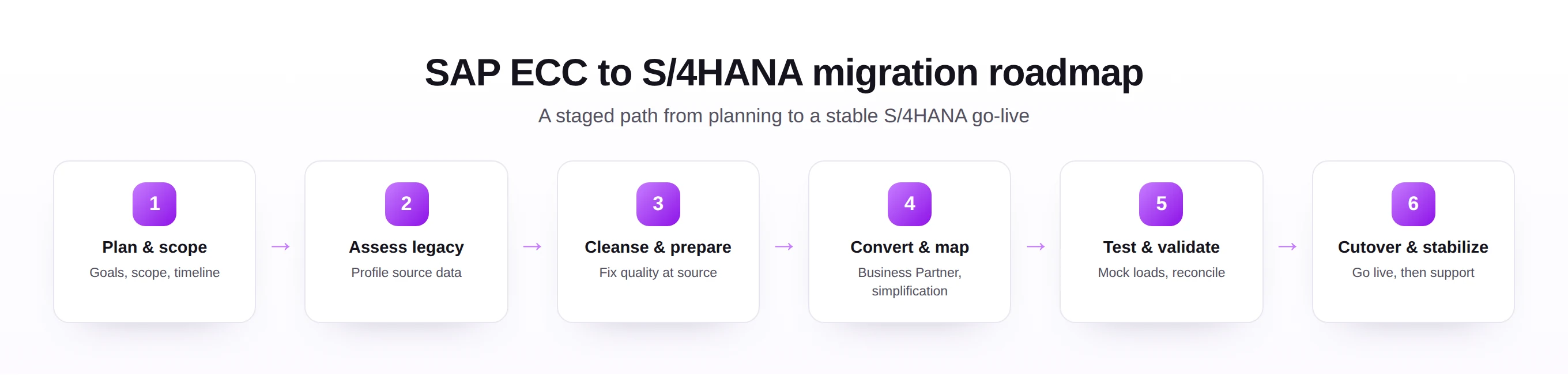

SAP ECC to S/4HANA migration roadmap with staged phases from planning to a stable go-live.
Diagram A staged path moves an ECC landscape to a clean, reconciled S/4HANA go-live.

Why organizations migrate. Mainstream support timelines and the pull of a modern data model push most SAP customers toward S/4HANA sooner or later, and the transition is a natural moment to modernize the data itself.

Business Partner conversion. S/4HANA unifies customers and vendors under the Business Partner model. Reconciling the two source objects into one entity, with the right roles, is one of the defining data tasks of the move.

Simplification impacts. Several tables and structures are simplified or replaced in S/4HANA, so mappings written for ECC cannot simply be reused. Each affected object needs to be revisited against the new model.

Migration considerations. Teams have to decide between a fresh start and a conversion, how much history to carry, and how to keep the legacy system available for reference. These choices shape the whole plan and are best made early.

Underpinning all of it is data quality. The cleaner the ECC data before the move, the more predictable the S/4HANA go-live, which is why strong master data governance pays off long before the project begins.

SAP data migration tools

There is no single right tool. Most projects combine a few, choosing by data volume, complexity, and how repeatable the loads need to be.

ApproachWhere it fits
SAP S/4HANA Migration CockpitSAP's standard tool for S/4HANA loads, with predefined objects and templates.
LSMWA long-standing ECC tool still used for legacy loads, though newer options are preferred for S/4HANA.
BAPIsStandard SAP interfaces that post data through the same logic as the application, with full validation.
APIsProgrammatic interfaces for integrating and loading data from external systems.
Excel-based toolsSpreadsheet-driven loaders that suit business users preparing and validating data in a familiar format.
Automation platformsTools that combine mapping, validation, approval, and logging to make loads repeatable and auditable.

The point is to match the method to the object. A handful of complex configuration records may justify careful manual work, while thousands of similar master records are better handled by a validated, repeatable load. The right SAP automation tools let teams keep that balance without writing code for every object.

When choosing between approaches, a few questions usually settle it: how many records of this object exist, how complex are the rules, and how many times will the load run. High volume and high repetition point toward validated automation, while a small set of intricate records may warrant a more hands-on method.

SAP data quality and migration readiness

Readiness is mostly about data quality. A project is ready to migrate when the source data has been measured, cleaned, and proven against the target rules.

  • Data assessment, profiling the source to quantify gaps, duplicates, and invalid values before committing to a plan.
  • Cleansing, fixing those issues at the source where possible, so corrections are not lost at the next extract.
  • Validation, testing records against SAP rules so failures surface in a spreadsheet, not during cutover.
  • Governance, agreeing who owns each object and who signs off that it is ready.
  • Readiness planning, setting clear entry and exit criteria for each phase so progress is measurable.
📊
The case for cleaning first. Gartner has put the average annual cost of poor data quality at $12.9 million per organization, a figure that explains why migrating dirty data is rarely a saving. Source: Gartner.
📈
Quality is a revenue issue. MIT Sloan Management Review research has estimated that bad data can consume between 15 and 25 percent of a company's revenue, so migration is the wrong moment to cut corners on quality. Source: MIT Sloan Management Review.

It helps to make readiness an explicit decision rather than an assumption. Agreeing a clear go or no-go checkpoint for each object, with measurable criteria, turns readiness from a feeling into a fact and gives everyone the same picture before cutover begins.

SAP data migration best practices

A few habits separate migrations that land on time from those that slip.

  • Govern the data with clear standards for what a valid, complete record looks like.
  • Assign ownership so every object has a named business owner accountable for its readiness.
  • Test repeatedly with mock loads, not a single rehearsal close to go-live.
  • Validate early and often, checking against SAP rules from the first extract onward.
  • Plan the cutover in detail, with a timed sequence, owners, and a fallback position.
  • Document mappings and decisions so the migration is repeatable and defensible.
  • Manage the change, keeping business users informed so they trust the new data on day one.
💰
Cheaper early than late. The familiar 1-10-100 rule applies neatly to migration: a record costs about one unit to get right at entry, roughly ten to fix later, and around a hundred once a bad value is live and feeding reports. Cleansing before the load keeps the cost at the low end.

Above all, rehearse. A cutover that has been run end to end several times, against realistic data and within the real time window, removes most of the suspense from go-live. The teams that sleep well the night before are the ones who have already done the load more than once.

SAP data migration framework

A simple framework keeps a migration balanced, bringing five dimensions together around one goal: a trusted go-live.

SAP Data Migration framework showing the people, process, technology, controls, and metrics behind a clean migration.
Diagram People, process, technology, controls, and metrics combine to deliver a clean migration.
People
Business users, data owners, and the migration team who plan and run the loads.
Process
Discovery, mapping, testing, and cutover, run as a repeatable sequence.
Technology
SAP tools, automation, and validation that move and check the data.
Controls
Auditability, reconciliation, and governance that keep the migration defensible.
Metrics
Data completeness, data quality, and migration readiness that show whether it is safe to go.

The strength of the framework is balance. People without process leads to inconsistent loads; technology without controls makes mistakes faster; metrics without ownership become reports nobody acts on. Keeping the five dimensions in step is what carries a migration from plan to a steady production system.

SAP data migration implementation roadmap

This roadmap turns the framework into an order of work, from defining scope to a stable production system.

  1. Define scope. Decide which objects, systems, and history are in and out.
  2. Assess source systems. Profile the data and surface quality issues early.
  3. Clean data. Correct and deduplicate records, ideally at the source.
  4. Define mappings. Agree how each source field becomes a target field.
  5. Build migration processes. Construct repeatable extract, transform, and load routines.
  6. Test migration. Run mock loads, reconcile, and fix what fails.
  7. Execute cutover. Run the live load in the planned sequence and window.
  8. Validate results. Reconcile counts and balances against the source.
  9. Stabilize production. Support users, monitor, and close out open issues.
Build repeatability in. The steps that get tested most are the ones that run more than once. Loading from Excel through validated, logged routines means the rehearsal and the real cutover use the same process, so go-live holds no surprises.

The order of these steps is deliberate. Building load processes before the mappings are agreed, or attempting cutover before testing has settled, tends to multiply the work rather than save time. Each step earns the right to begin only when the previous one is genuinely complete.

Common SAP data migration mistakes

Knowing the usual traps makes them easier to design out.

⚠️
Watch for these patterns: underestimating data quality issues, which quietly inflates every later phase; insufficient testing, so problems appear at cutover; poor ownership, where no one is accountable for an object being ready; weak governance, so standards are unclear; last-minute cutovers with no slack; and incomplete validation, where reconciliation is rushed or skipped.

Almost all of these are planning failures rather than technical ones. They are avoided by starting the data work early, naming owners, and refusing to treat testing and reconciliation as optional.

The future of SAP data migration

Migration is steadily becoming faster and less manual, though the fundamentals of clean data and careful reconciliation remain.

  • AI-assisted mapping, suggesting how source fields should line up with the target model.
  • Automated validation, checking large volumes against SAP rules with little manual effort.
  • Migration accelerators, prebuilt objects and templates that shorten the build phase.
  • Cloud migrations, as more organizations move SAP workloads to cloud platforms.
  • S/4HANA modernization, with conversions used as a chance to simplify and standardize data.

The tools will keep improving, but the lesson does not change: a migration succeeds on the quality of the data going in and the rigor of the reconciliation coming out.

What stays constant is the human judgment around the automation. Deciding what is in scope, accepting the risk at cutover, and signing off that the data is right are calls people make, supported by better tooling rather than replaced by it.

SAP data migration and Excel-to-SAP automation

For all the platforms involved, Excel remains at the center of most migrations, because it is where business users prepare, review, and correct their data.

Why Excel still matters. The people who know whether a vendor or material is right tend to work in spreadsheets. Keeping data in Excel for cleansing and review means the experts can do the work without learning a new tool.

Mass migration use cases. Bulk loads of master records, opening balances, and open items are a natural fit for a spreadsheet-driven approach, where a single template can carry thousands of rows.

  • Upload templates give each object a clear, consistent structure to fill in.
  • Validation against live SAP catches errors before the load, not after.
  • Automation benefits turn a manual, error-prone load into a repeatable, logged routine.

The same loaders used at go-live keep earning their place afterward, for the steady stream of new records every system needs. That is the bridge from a one-off migration to ongoing Excel to SAP automation and wider SAP process automation, covering objects from the vendor, customer, and material masters to journal entries, purchase orders, sales orders, and goods movements.

From cutover to business as usual. PostNow loads master and transactional data from Excel, validates it against SAP, and posts it through standard interfaces with a full log, so the routine that proves itself during migration keeps running long after go-live.

Used this way, a migration stops being a single dramatic event and becomes the first run of a process the business keeps. The templates, validations, and logs built for go-live are exactly what is needed to keep SAP data clean for the long run.

Frequently asked questions

What is SAP Data Migration?
SAP Data Migration is the process of moving data from legacy or existing systems into SAP, covering master data such as vendors and materials and transactional data such as open items and orders, so the new system starts with accurate, usable records.
What are the phases of SAP Data Migration?
A typical SAP data migration moves through assessment, data discovery, cleansing, mapping, transformation, validation, testing, cutover, and post go-live support. Each phase lowers the risk that incomplete or incorrect data reaches the new system.
What tools are used for SAP Data Migration?
Common options include the SAP S/4HANA Migration Cockpit, the legacy LSMW, BAPIs and APIs for programmatic loads, and Excel-based tools and automation platforms that prepare, validate, and load data. The right mix depends on volume, complexity, and timeline.
How do you migrate data from SAP ECC to S/4HANA?
An ECC to S/4HANA migration involves assessing legacy data, cleansing it, handling the Business Partner conversion and other simplifications, mapping fields to the new model, then testing loads and reconciling results before cutover. Clean source data is what keeps the move predictable.
What are the biggest SAP migration challenges?
The hardest parts are usually poor data quality and duplicates in legacy systems, mapping complexity, limited testing time, and cutover risk. Most overruns trace back to underestimating how much cleansing the source data needs.
